Every valid capital call or draw request needs six things on one page: the purpose of the funds, the exact amount due per investor, a settlement date, the investor’s remaining unfunded commitment, a citation to the governing document section that authorizes the call, and wire instructions delivered through a secure channel, never plain email. Skip any one of these and you risk an invalid notice, a delayed wire, or a rejected draw.
For equity capital calls, that six-point notice is the whole job. For lender construction draws, the notice is just the cover sheet. You also need a complete draw package built on the AIA G702/G703 pay application format, because incomplete lien waivers remain the single most common reason draws get sent back.
- Confirm LPA/operating agreement authority for the call amount and purpose
- Draft the notice using the six mandatory fields above
- Deliver through a secure investor portal, not email attachments
- For draws, assemble the full lender package (G702/G703, schedule of values, waivers, invoices)
- Reconcile every wire against the reference code within 24 hours of receipt
The ILPA capital-call template and platforms like CR Equity AI both exist to make this checklist repeatable instead of reinvented every quarter.
Key Takeaways
A capital call or draw request is only valid when the notice contains every required field, moves through a secure channel, and gets reconciled against the governing document within days of funding.
| Point | Details |
|---|---|
| Six mandatory fields | Purpose, per-investor amount, due date, unfunded balance, LPA citation, and wire instructions must all appear. |
| Notice timing | Standard windows run 10 to 15 business days unless the governing document authorizes an expedited call. |
| Security first | Deliver through a portal, never embed wire details in email, and verify changes by phone. |
| Draw packages need lien waivers | Incomplete or missing waivers are the leading cause of construction draw rejections. |
| Reconcile within 24 hours | Match wires by reference code, post to capital accounts, and update unfunded balances promptly. |
| CR Equity AI streamlines execution | Its portal, pro rata automation, and draw-package bundling reduce the manual steps that cause rejections and delays. |
Authoritative Templates and Primary Sources
- ILPA capital-call template: fund and LP-level fields plus worksheet for reconciliation
- AIA G702/G703: standard pay application forms for construction draws
- Rabbet’s draw-package standard: document checklist and rejection causes
- Built’s lender draw-request guide: procedural timeline guidance
- Crowdfundlawyer’s capital-call mechanics primer: legal default process
This article is general information, not a substitute for advice from a qualified financial advisor. Consult a qualified financial professional about your own circumstances before acting on anything here.
Table of Contents
- How Do You Prepare a Capital Call Notice?
- What’s the Safest Way to Deliver and Track a Capital Call?
- What Documents Belong in a Lender Draw Package?
- How Do You Reconcile a Capital Call After Funds Arrive?
- What Mistakes Cause Capital Calls or Draws to Fail?
- What Legal Requirements Apply to a Capital Call?
- An Operational Perspective on Running Capital Calls
- How CR Equity AI Reduces Capital Call and Draw Friction
- Sources
- FAQ
How Do You Prepare a Capital Call Notice?
A valid notice is a document, not an email blast. It needs fund or entity name, call number, notice date, settlement date, total call amount, per-investor amount, remaining unfunded commitment, stated purpose, a breakdown by use (investment, fees, expenses), the specific LPA or operating agreement section authorizing the call, and wire instructions.
Calculating the per-investor amount is arithmetic, but getting it wrong is expensive. Multiply each limited partner’s commitment percentage by the total call amount, then confirm the result against their remaining unfunded balance so you never call more than what’s left on their commitment.
Standard notice periods run 10 to 15 business days, giving investors time to move funds without scrambling. Expedited windows are allowed only when the governing document explicitly permits them, such as for a time-sensitive acquisition closing.
- Fund/entity name and call number
- Notice date and settlement (due) date
- Total call amount and per-investor breakdown
- Remaining unfunded commitment balance
- Purpose and use-of-funds breakdown
- Governing-document citation authorizing the call
- Verified wire instructions
Pro Tip: Pair a short narrative cover letter explaining “why now” with a separate, detailed worksheet formatted on the ILPA template. The letter builds investor confidence; the worksheet gives your fund administrator the line-item detail needed for reconciliation.
What’s the Safest Way to Deliver and Track a Capital Call?
Deliver through a secure investor portal and use email only to notify investors that a document is waiting. Wire instructions should never appear in an email body. Portal-based delivery creates an immutable activity log showing exactly who opened the notice and when, which matters if a dispute ever surfaces.
Before any wire moves, run this verification checklist:
- Confirm wiring instructions match the static, pre-approved bank details on file
- Verify any change to those instructions through an independently verified phone contact, never a reply email
- Restrict who inside your organization can edit wire details with role-based access controls
- Log every notice delivery and confirmation inside the portal
Timing carries its own risk. Issue calls early in the week to avoid weekend processing delays, account for investor time zones, and send a reminder at T-2 business days. This kind of predictable, secure handling is increasingly treated as a governance function, not clerical follow-up, and manual email processes carry documented fraud and business-email-compromise risk that a portal largely eliminates.
What Documents Belong in a Lender Draw Package?
Lenders reviewing milestone draws expect a specific stack of documents, in a specific order, every time. Missing or incomplete lien waivers are the number one cause of draw rejections industry-wide, so that’s the first item to double-check before you submit anything.
- Cover letter and draw summary (sources and uses)
- Pay application: AIA G702/G703 or an equivalent sworn statement
- Updated schedule of values
- Invoice and receipt backup, in schedule-of-values order
- Change-order log
- Stored materials documentation
- Conditional lien waivers (current period) and unconditional waivers (prior period)
- Inspection photos
- Current insurance certificates and permits
Formatting rules matter as much as content. The G702 summary must tie exactly to the G703 continuation sheet, invoices need to follow schedule-of-values order rather than random sequence, and conditional waivers belong directly behind the pay application they correspond to, not buried at the back of the package.
| Rejection Cause | Why It Happens | Fix Before Submission |
|---|---|---|
| Incomplete lien waivers | Wrong waiver type or missing signature | Match waiver type to payment status, confirm signatures |
| Dual-budget mismatch | Owner budget and lender budget diverge over time | Reconcile both budgets before every draw |
| Unreconciled change orders | Change order not reflected in schedule of values | Update SOV and log before submitting |
The dual-budget problem, where the owner’s internal budget drifts from the lender’s approved budget, is one of the most persistent sources of friction on multi-draw construction deals. Reconciling both before each submission heads off the majority of lender pushback.
How Do You Reconcile a Capital Call After Funds Arrive?
Reconciliation is where a lot of otherwise solid capital calls fall apart administratively. The process is sequential, and skipping a step creates accounting gaps that surface months later at audit.
- Match each incoming wire to its investor using the reference code and exact dollar amount
- Flag and resolve any discrepancy within 24 hours, before it compounds across multiple LPs
- Post the contribution date and amount to the investor’s capital account
- Update the investor’s remaining unfunded commitment balance
- Record the transaction in your fund-level cash-flow ledger
The ILPA worksheet fields exist precisely for this step. They capture fund-level and LP-level cash-flow detail in a format auditors already recognize, which speeds up year-end review.
- Carry calculations tied to this contribution
- Management-fee offsets applied against the call
- Cumulative contributions to date
- Variance explanation when actuals differ from the original forecast

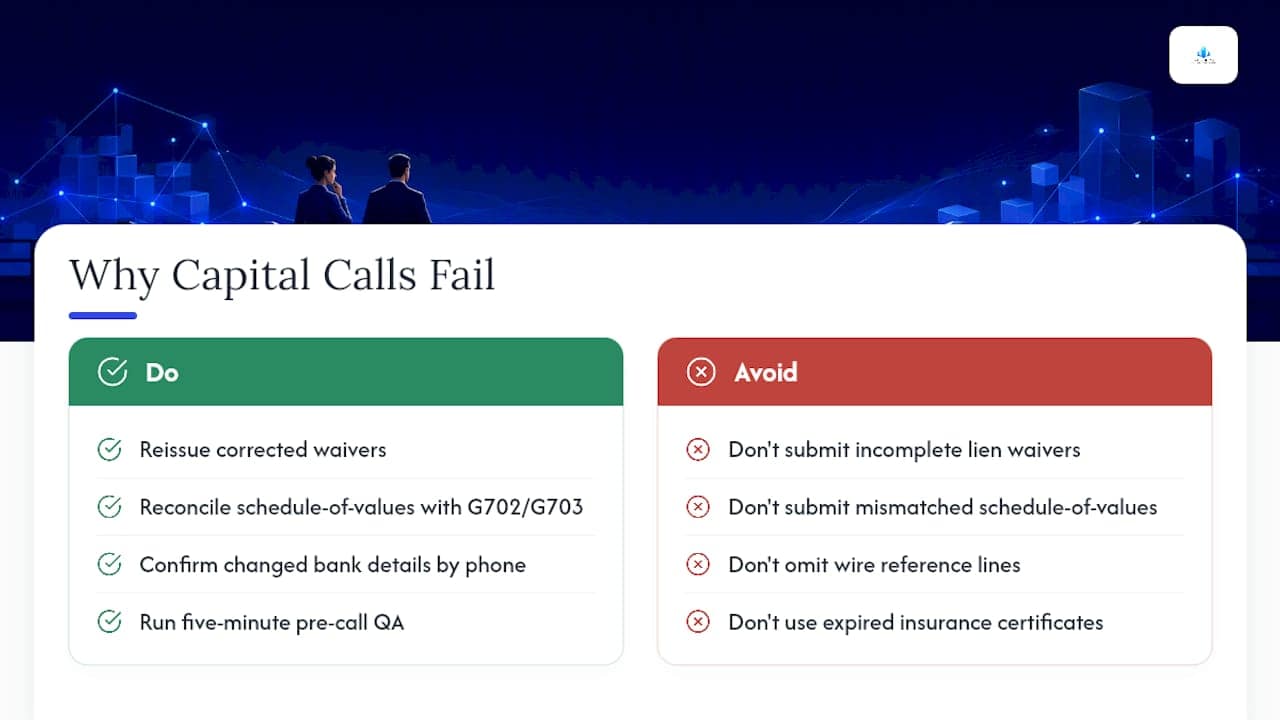

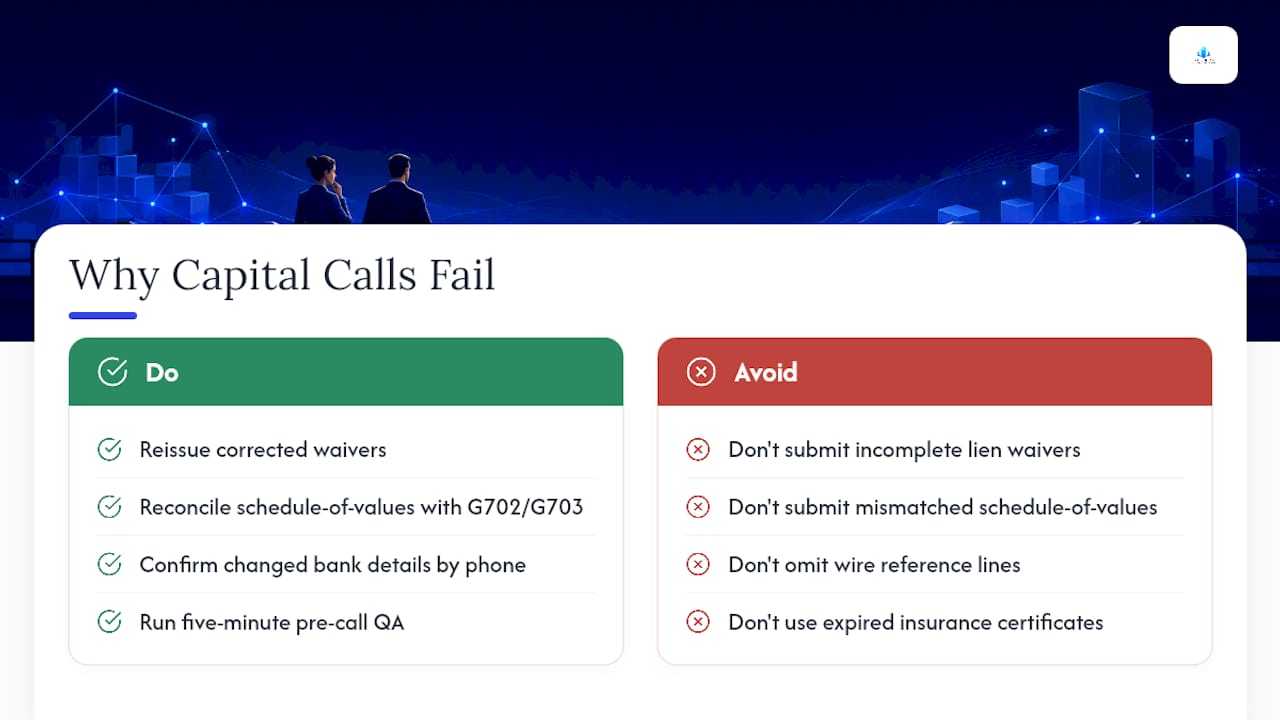

What Mistakes Cause Capital Calls or Draws to Fail?
Most rejections trace back to a short list of repeat offenders: incomplete lien waivers, schedule-of-values totals that don’t match the pay application, wrong or missing reference lines on wires, expired insurance certificates, and wire instructions embedded directly in an email instead of a secure portal.
The fixes are usually fast once you know where to look. Reissue corrected waivers rather than patching them. Reconcile the schedule of values against the G702/G703 before submission, not after a rejection. Confirm any changed bank detail through an established phone contact. And when an investor misses a call deadline, issue a formal, documented cure notice rather than an informal reminder.
Pro Tip: Run a five-minute pre-call QA pass against your notice or draw package before it leaves your desk. Catching a missing waiver internally costs five minutes; catching it after a lender rejection costs a week.

What Legal Requirements Apply to a Capital Call?
The LPA, operating agreement, or subscription agreement, not the sponsor’s preference, defines who has authority to call capital, what the notice must contain, how long investors get to fund, permitted uses of the money, and the remedies available on default. A notice missing any required element is not a valid call, regardless of intent.
- Confirm calling authority under the governing document before drafting the notice
- Cite the specific section authorizing the call amount and purpose
- Issue a formal default notice, citing the governing provision, if an investor fails to fund
- Apply the cure period defined in the documents, typically 5 to 30 days
- Document interest, fees, dilution, or forfeiture only as the agreement authorizes
- Preserve the notice, proof of delivery, investor confirmations, and reconciliation records
| Point | Details |
|---|---|
| Notice validity | A call missing a required field or citation is not enforceable under the LPA. |
| Cure period | Governing documents typically set a 5 to 30 day cure window after formal default notice. |
| Recordkeeping | Preserve delivery proof and reconciliation records to keep remedies available. |
An Operational Perspective on Running Capital Calls
Capital calls fail administratively far more often than legally. The fix isn’t better lawyers, it’s better ownership. Assign one person per call who runs the pre-flight QA checklist and signs off before the notice goes out. Ambiguity about who checks the wire instructions is how wire fraud gets a foothold.
A centralized portal that houses notices, attachments, access logs, and reconciliation status in one place beats a folder of email PDFs every time. Publish quarterly forecasts so investors see calls coming, consolidate fee and investment calls where the documents allow it, and issue notices early in the week so approval cycles don’t stall over a weekend. Automating pro rata math and bank reconciliation removes the two places where manual error creeps in most.

How CR Equity AI Reduces Capital Call and Draw Friction
Everything on this checklist, from notice generation to draw-package assembly to wire reconciliation, is a coordination problem before it’s a paperwork problem. CR Equity AI is built around collapsing that coordination gap: sponsors get a secure investor portal for notice delivery and access logging, automated pro rata calculations that cut the manual math out of every call, and structured document bundling for milestone draw packages so a lender review doesn’t stall on formatting.
If you’re managing a ground-up build, milestone draws are where the checklist matters most, and CR Equity AI’s construction loan program funds against your own draw schedule rather than forcing you into a generic template. Sponsors working fix-and-flip timelines can move just as fast through the fix and flip program, and anyone weighing broader financing options can review the full lineup on the commercial lending overview. Get a quote through the loan calculator to see funding terms before your next call or draw goes out.
Sources
- Rabbet – The construction draw package standard: what every lender-ready package must include
- ILPA – Best Practices: Capital Calls & Distribution Notices (Template)
- Capital Call Best Practices: Timing, Wording, Delivery, and Security – Pinnacle Fund Services
- Capital Call Mechanics and Investor Default Remedies in Real Estate Funds and Syndications – Crowdfundlawyer
- Construction Draw Request Process: A Lender Guide | Built
FAQ
What Must Appear on a Valid Capital Call Notice?
The notice needs the purpose of the call, the exact per-investor amount, a settlement date, the investor’s remaining unfunded commitment, a citation to the governing document section authorizing the call, and wire instructions delivered through a secure channel.
How Long Should a Capital Call Notice Period Be?
Standard practice runs 10 to 15 business days, though governing documents can authorize a shorter, expedited window for time-sensitive needs like an acquisition closing.
What’s the Top Reason Construction Draws Get Rejected?
Missing or incomplete lien waivers are the leading cause of draw rejections, followed closely by mismatches between the owner’s budget and the lender’s approved budget.
Should Wire Instructions Ever Go in an Email?
No. Wire instructions belong in a secure investor portal, and any change to bank details should be verified through an independently verified phone contact rather than a reply to an email.
How Fast Can Milestone Draws Be Processed?
Manual review often takes 5 to 10 business days, while centralized, automated draw platforms like CR Equity AI’s construction program can compress that to a matter of days by validating intake and routing exceptions early.
Recommended
- Your commercial lending checklist: secure financing fast | CR Equity AI
- Private-Lender Loan to Value Ratio Benchmarks: 2026 Guide | CR Equity AI
- DSCR Cash-Out Refinance: Exactly How Much You Can Pull Out | CR Equity AI
- Small Balance Commercial Loans: What Each Asset Class Actually Gets | CR Equity AI
